Operational Payoff · Operations consulting - Find out what's wrong.
Delivered, no result: was necessary work left unassigned?

The initiative was approved. The tool is installed, the status is green, the project closed. Six months later the business runs exactly as it did before, with one more system to maintain, and you are the one being asked why.
Delivered initiatives usually already have explanations: the idea was wrong, the team was slow, training fell short, adoption was weak, priorities changed, or the system did not fit the work. Any one could be right. Another possibility is that necessary work was never assigned.
Emergent Skills conducts a focused operational investigation. We test those explanations against the work and the evidence rather than assuming missing work is the cause. The Snapshot also checks the business result, delivery prerequisites, the work path, conditions around execution, and other plausible explanations.
Before you fund the fix, find the right problem.
Four common areas we check for necessary work and ownership
Job 1
Make it producible here
Who is making it work with your data, your volumes, and your exceptions? If the vendor owns it, who is accountable for delivery?
Job 2
Make it fit the interfaces
Who got the teams it touches to agree on definitions and handoffs? Who owns carrying those agreements through?
Job 3
Take out the old process
What has been switched off since this started? Does retaining the old process interfere with the intended result?
Job 4
Settle who absorbs the disruption
Who lost something in this change, and what did they get for it? Who bears the disruption, and is there evidence that it is affecting the work?
Where necessary work lacks an owner, we ask for a name, not a department.
\$1,500 USD
Fixed scope. One initiative.
Written input
From people involved in the work (typically 6 to 8)
90-minute session
With up to three participants
Written report
Within 24 hours of the session
15-minute walkthrough
With the sponsor or result owner
Follow-up
After an agreed test or evidence review
The 90 minutes is the working session, not the whole investigation. Written input and available records are reviewed around one tightly scoped result so the session can focus on reconciling what happened, testing explanations, and deciding what evidence or action is needed next.
Led by Jim Wilde, founder of Emergent Skills. Nine years as lead consultant at the MTA on mta.info and the NYC subway countdown clocks. Decades in enterprise systems before that.

How necessary work can go unowned
The idea gets a press release. The jobs get nothing.
A stalled initiative can have a sponsor who owns the outcome, a project manager who owns the schedule, and a vendor who owns the software. Yet necessary work can still lack an owner: making it producible, fitting the interfaces, removing the old process where needed, or negotiating the cost of the change.
This work can cross team boundaries, making ownership unclear. It can also involve removing an old process or changing a handoff rather than adding another visible feature. Check whether the plan assigns that work and gives its owner the authority to carry it through.
Companies fund what gets a press release. The result is an initiative that is approved, installed, and green on the status report while the business runs exactly as it did before.

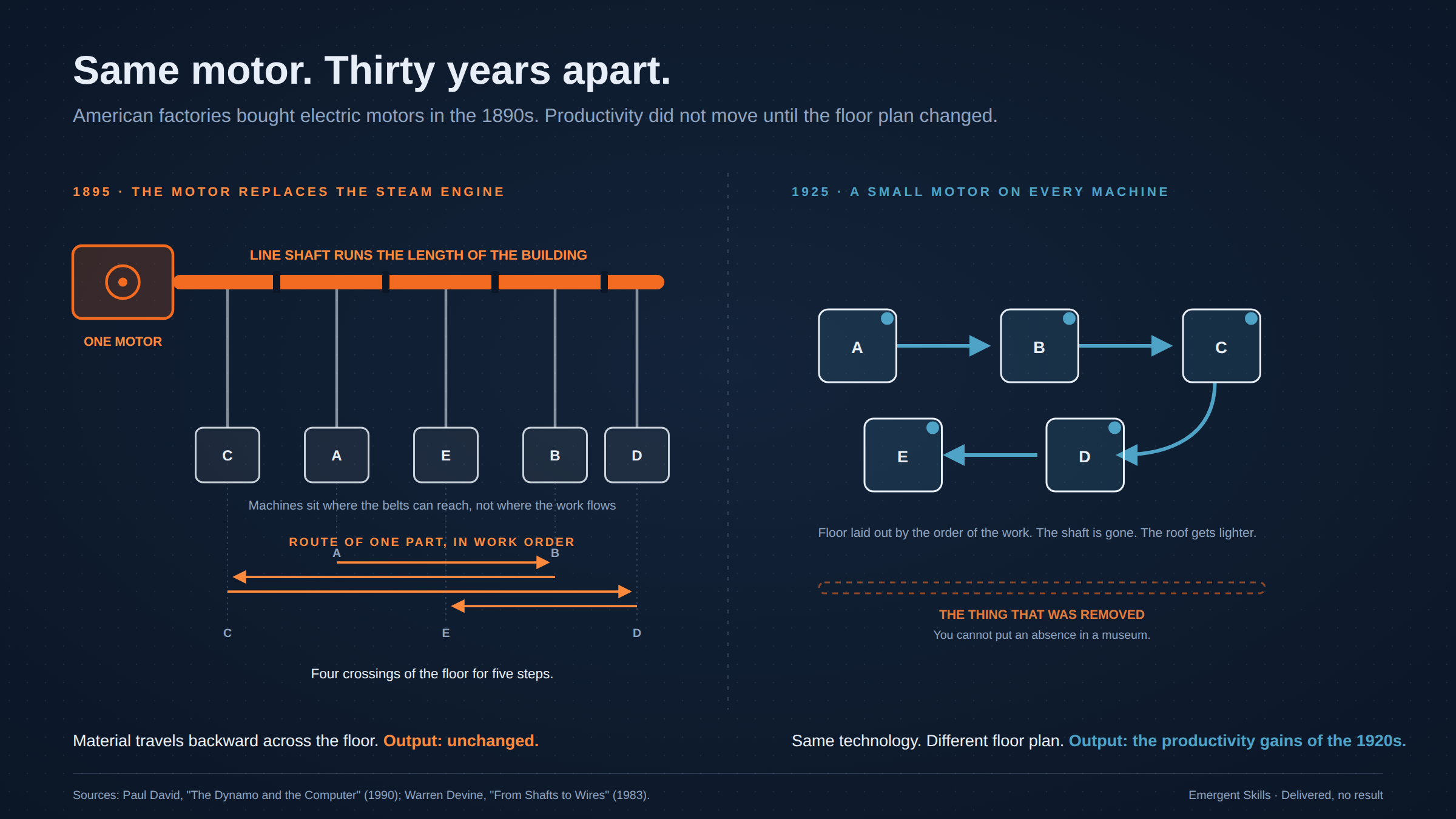

The pattern is not new. Factory electrification brought larger productivity gains as manufacturers combined electric motors with changes to factory layouts and production methods. Powering machines individually allowed engineers to arrange them around the flow of work. That redesign helped manufacturers gain more from electrification, alongside other technological and economic changes. David and Wright’s historical analysis describes these interacting changes.
Penicillin’s development required research teams, improvements in fermentation, and industrial production work. For the barcode, the 1952 patent preceded the 1973 industry standard; advances in scanning and computing also helped make adoption practical.

What you get
Findings, costs we can establish, and the next decision.
This is a Stalled Priority Snapshot scoped to an initiative that closed without producing its result. The investigation starts with the intended result and checks its validity, priority, delivery prerequisites, and external dependencies. We then examine necessary work and ownership, where work is stuck, whether the conditions around it are adding errors and rework, and other plausible explanations the evidence supports.
Whether necessary work lacks an owner
For relevant work, the owner identified, any supported assignment gap, and what remains unclear, with the evidence behind the finding.
Who could own any missing work
Where assigning work is justified, the role, the authority it needs, and an effort estimate where supported. Put it on the plan as work, with a date, the same as any deliverable.
What the shortfall costs
Extra labor costs and deferred benefits reported separately, with estimates only where supported and the arithmetic and assumptions beside each figure. A weekly estimate where the evidence supports one.
The decision
Assign missing work, redesign around it, change another condition, or stop — whichever the evidence justifies. If the evidence points to a funding gap, a dependency, an initiative that should not proceed, or another explanation, we say so. If the cause remains unresolved, we specify the next evidence step.
The readout is written for the sponsor. It explains what the evidence supports, what remains uncertain, and the next decision or evidence step. When the result crosses teams or the explanation is disputed, an outside finding tied to the record can also give the sponsor something independent to take back across the organization.
Is this the right fit?
Bring one initiative that closed green and changed nothing.
Best fit: an AI rollout, software implementation, process change, reorganization, or integration that reached its delivery milestone, with a business result that has not started or has stalled well short of the case. A sponsor or operations leader owns the result and can put a name against a job. The value still at stake justifies the fee and your team’s time.
Not a fit: a project that has not delivered yet. That is a stalled priority, and the standard Snapshot is the place to start. Also not a fit when the result was never defined, since there is nothing to trace the work back from. We confirm fit before booking and decline when the answer is already clear.
Where this sits. One initiative is a Snapshot. Several initiatives with the same shape, or a portfolio a PE operating partner wants checked, is a Work Demand Diagnostic question. Each step needs its own business case. No commitment past the Snapshot.
Start with one initiative
Find out what kept the result from starting.
\$1,500 USD, fixed scope. Written report within 24 hours of the session. You can upload a PO, request a quote, or tell us the PO will follow.
